When do you need a professional project manager?
Not every project needs a dedicated project manager. The question is whether the work has outgrown the organisation’s existing capacity to coordinate it.

Good project management gives an organisation someone who is focused on coordinating the work required to deliver the intended outcome.
A project manager can contribute before delivery begins, helping to turn an idea into a credible business case and delivery approach. Their role may then extend through procurement, mobilisation, delivery and transition into operations, including early warning when resources, decisions, risks or assumptions no longer support the plan.
If dedicated project management is likely to be required, involving that person before procurement and contracting can be particularly valuable. Once supplier scopes, responsibilities and milestones have been agreed, integration problems can be harder and more expensive to correct.
A dedicated project manager is not always needed. Often projects can be managed within existing roles. That is more likely when the outcome is familiar, the delivery approach is understood and the important decisions sit with a clear owner.
Dedicated project management becomes more valuable when several of these conditions are present: the work crosses departments or suppliers; the outcome or delivery approach is unfamiliar; important dependencies or decisions are time-sensitive; specialist internal resources are scarce; business and technology change must land together; or the consequences of delay or failure are significant.
Where time and budget are fixed, trade-offs may be required in scope, quality, business readiness or the timing of expected benefits. A project manager can make those trade-offs explicit and escalate them before they are made by default.
Who is managing the whole outcome?
You sometimes hear something along the lines of “we don’t want project managers managing project managers,” meaning we should be able to get the work done without duplicating resources.
The concern about duplication is reasonable, but the client-side and supplier-side roles are different.

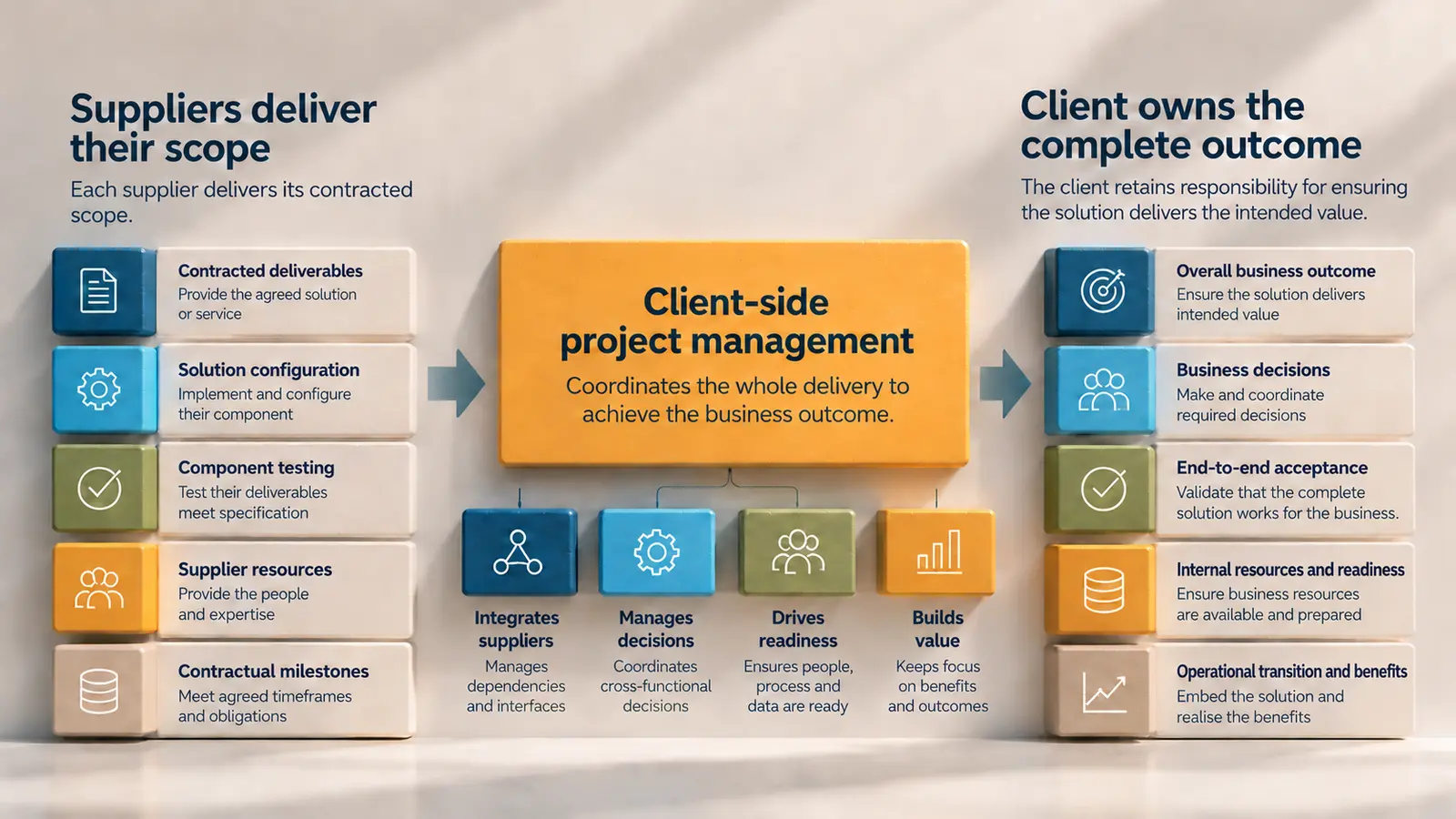

Where suppliers are involved, even a conscientious supplier will normally manage its own contracted scope. It is the client who ultimately needs to bring inputs from different parties together into a complete business result.
A prime vendor may coordinate subcontractors and accept responsibility for technical integration. The client still retains responsibility for its own decisions, resources, acceptance, business readiness and oversight of the prime vendor.
An ERP implementation, for example, may divide the work between a SaaS software vendor, an implementation partner and specialists responsible for data or integration with other operating systems. Finance and operations still have to make decisions, provide people, prepare data, test complete end-to-end processes and eventually take ownership of and be able to operate the new system.
Every supplier can meet its contractual obligations while gaps between their individual scopes leave the client unable to proceed as planned.
A client-side project manager can identify where contractual boundaries or incentives are working against coordination and raise those issues through the appropriate commercial process.
The supplier’s project manager cannot usually be expected to do all of that on the client’s behalf.
Does the project have the resources it needs?
Most projects use a mixture of dedicated project staff and people contributing alongside their pre-existing roles. A project manager develops a practical view of what the delivery plan requires, when particular contributions will be needed and whether the people concerned will actually be available.
Experienced project managers are used to coordinating resources across functions, including people who do not report to them and may only be needed for a small part of the project. They can identify a shortfall early, adjust the sequence of work or negotiate access to the people required.
If the gap cannot be resolved within the project, the project manager can take it to the sponsor or management with a clear account of the effect on delivery and the expected benefits. Management can then change priorities, provide additional resources or reset the commitments while there are still practical options.
Where several projects depend on the same people or shared services, the project manager can also interlock the plans and provide useful information to programme governance about competing demands.
Is the business ready for what the project is delivering?
Suppliers can support change and readiness, but the client still owns the internal decisions and preparation required for go-live. A technically successful implementation can fall short of its business case if process changes, operational readiness or expected benefits are deferred to protect the deadline. Those trade-offs should be visible to management rather than disappearing into project reporting as work to be completed later.
What would failure cost?
The cost of appointing a project manager is visible at the outset.
The cost of weak project management usually appears later through rework, delay, contract disputes or disruption during implementation. By then, management has fewer options and less time to use them.
Decide what the work needs
The appropriate level of support will vary.
Adding a project manager without clear authority or accountability can create another reporting layer rather than improve delivery.
Some projects need stronger governance and a capable internal lead. Others need part-time client-side management through a difficult phase. A high-risk or heavily integrated programme may need a full-time project manager from the beginning.
Appointing a project manager does not transfer ownership of the business outcome. The sponsor still owns the business case, sets priorities and makes key organisational decisions. The project manager coordinates delivery and makes risks, trade-offs and gaps visible.
Before appointing anyone, establish whether the sponsor has the time, experience and authority to do the job. Supplier plans should connect into one delivery plan, and the internal people expected to make decisions or complete project work must actually be available.
Merva can conduct a short client-side delivery review before a project begins or when an existing project is losing momentum. The review identifies gaps in ownership, capacity and integration, then recommends the lightest level of support likely to work.
That may mean clearer governance, part-time client-side leadership or a full-time project manager. The aim is to give the project enough management to deliver the result without adding unnecessary overhead.
If your project has outgrown its current arrangements, talk to Merva.
